1. Verify the Contracting Entity and the Agreement'S Legal Form
Identify the contracting parties, payment obligations, and assets potentially exposed if the transaction fails.
Confirm Names, Authority, and Guarantees
Check the legal entity name against formation records and confirm the signer's authority under company approvals. If an owner or parent company is expected to back the obligation, require a separate guarantee rather than relying on its participation in negotiations.
Check When a Signed Record Is Required
New York General Obligations Law § 5-701 requires a signed writing for specified promises, including certain guarantees of another person's debt and agreements that, by their terms, cannot be performed within one year. For goods priced at $500 or more, UCC § 2-201 generally requires a record signed by the party against whom enforcement is sought. Merchant confirmations, specially manufactured goods, and accepted performance can create exceptions. These rules do not make every business contract subject to a writing requirement.
2. Make Performance and Payment Terms Verifiable
Even a clear price can leave payment timing disputed. Tie obligations to documented performance, not vague promises of "satisfactory completion."
Set Acceptance and Payment Triggers
Specify deliverables, inspection procedures, objection deadlines, and remedies for rejected work. For services, identify evidence of milestone completion. Allocate schedule and payment consequences when the customer delays necessary data, approvals, or access.
Control Conflicting Documents
Master agreements, purchase orders, and statements of work may conflict. Set a document hierarchy and identify who may approve amendments. Recurring supply agreements need clear quantity, delivery, and substitution terms.
3. Compare Liability Caps with the Risks They Leave Open
Read liability caps together with indemnity, warranties, and insurance; exceptions may leave important obligations uncapped.
Test Exclusive Remedies and Damages Exclusions
Check whether caps cover unpaid fees, third-party claims, and confidentiality losses. For goods, UCC § 2-719 permits remedy limits, but an exclusive remedy may fail of its essential purpose. Consequential-damage exclusions also face an unconscionability limit. Do not assume Article 2 governs services-only contracts.
Distinguish Indemnity from a Duty to Defend
Specify what triggers indemnification, whose claims qualify, when notice is due, and who controls a third-party defense. A promise to reimburse losses should not be treated as an express obligation to conduct the defense. For related enforcement questions, see indemnification claims. In construction-related contracts, General Obligations Law § 5-322.1 restricts agreements that shift liability for an indemnitee's own negligence causing injury or property damage.
4. Plan for Default, Termination, and Dispute Resolution

A missed payment or halted project calls for practical instructions. Review notice, termination, and dispute provisions together.

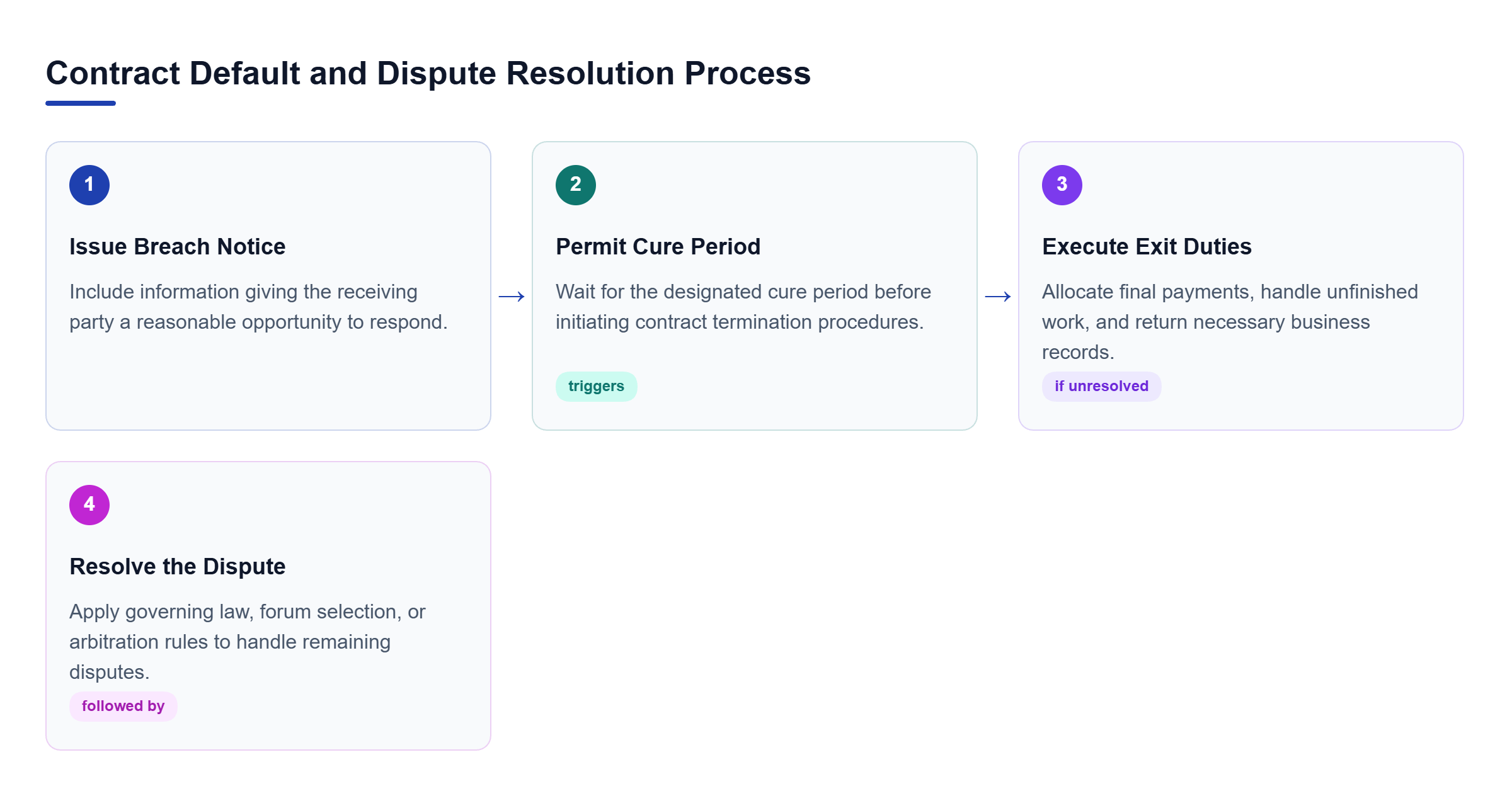

Define Notice, Cure, and Exit Obligations
Specify breaches that permit immediate termination or a cure period. Check notice addresses and delivery methods. State when the cure period begins and what information a breach notice must contain to give the receiving party a reasonable opportunity to respond. Allocate final payments, unfinished work, confidentiality, and transition duties. Clarify which obligations survive termination and whether either party must refund advance payments or return business records.
Separate Governing Law, Forum, and Arbitration
General Obligations Law § 5-1401 permits a New York-law choice for qualifying transactions of at least $250,000 despite a lack of other reasonable connection, with statutory exclusions. Section 5-1402 separately addresses qualifying transactions of at least $1 million and consent to New York courts by certain foreign or nonresident parties. Smaller transactions may still have enforceable forum clauses under other rules. The Federal Arbitration Act, 9 U.S.C. § 2, can govern arbitration agreements involving commerce, but it does not itself give federal courts jurisdiction over every dispute.
5. Assign Regulatory Approvals to the Right Party
A contract cannot substitute for required licenses. Identify applicable federal, state, or city approvals and assign responsibility for each.
Check the Activity, Not Just the Address
Regulators depend on industry, activity, and sometimes work location. Verify vendor licenses, expiration dates, and required endorsements. Local approvals may not satisfy state or federal rules; address permit lapses and ownership changes.
Identify the Actual Application Route
The NYC Department of Consumer and Worker Protection provides industry-specific licensing checklists and online applications. Other industries use their responsible agencies. Broader regulatory compliance covers continuing controls; the contract should assign approvals and renewals.
6. Evaluate the Court and Filing Rules before Selecting a Forum
New York County Supreme Court hears eligible business matters in its Commercial Division. Forum consent alone does not satisfy assignment rules.
Apply the Current Commercial Division Threshold
Under Uniform Rule 202.70, the ordinary monetary threshold in New York County is $500,000, excluding punitive damages, interest, costs, disbursements, and counsel fees. For equitable or declaratory claims, the rule measures the value of the action's object rather than automatically dispensing with the threshold. Specified matters, including shareholder derivative actions and business-entity dissolutions, have exceptions.
Distinguish Starting a Case from Division Assignment
Covered civil actions ordinarily begin through NYSCEF electronic filing, subject to exemptions. Under Rule 202.70(d), a party seeking Commercial Division assignment generally has 90 days after service of the complaint to file a Request for Judicial Intervention with the Commercial Division Addendum. Limited transfer procedures exist. This filing issue is separate from the merits discussed in commercial disputes.
7. Record the Business Decision before Anyone Signs
Management should record unresolved terms, proposed revisions, and who accepted significant contractual risks.
Use a Pre-Signing Checklist
- Verify the contracting entities, signer authority, and any separate guarantee.
- Match deliverables and acceptance tests to payment obligations.
- Compare liability limits with indemnity, insurance, and available remedies.
- Confirm notice procedures, cure periods, and termination costs.
- Assign licensing, renewal, and reporting responsibilities.
- Check whether the dispute clause points to a legally available forum.
Save the Approved Version and Supporting Records
Keep signed agreements, incorporated schedules, amendments, and approvals together. Document assumptions behind accepted liability exceptions. When performance or payment fails, the company can consult an agreed record instead of reconstructing scattered emails.
