1. Define Deliverables and Acceptance Standards

The scope clause should identify tasks, outputs, deadlines, and exclusions. “Strategic consulting” alone leaves uncertainty about whether the fee includes meetings, written recommendations, implementation, or follow-up support.
Distinguish Required Work from Expected Results
Specify each deliverable’s format and content, required client input, and the person authorized to approve it. Separate performance obligations from hoped-for outcomes: delivering a market analysis differs from guaranteeing increased sales.
Establish Review and Change Procedures

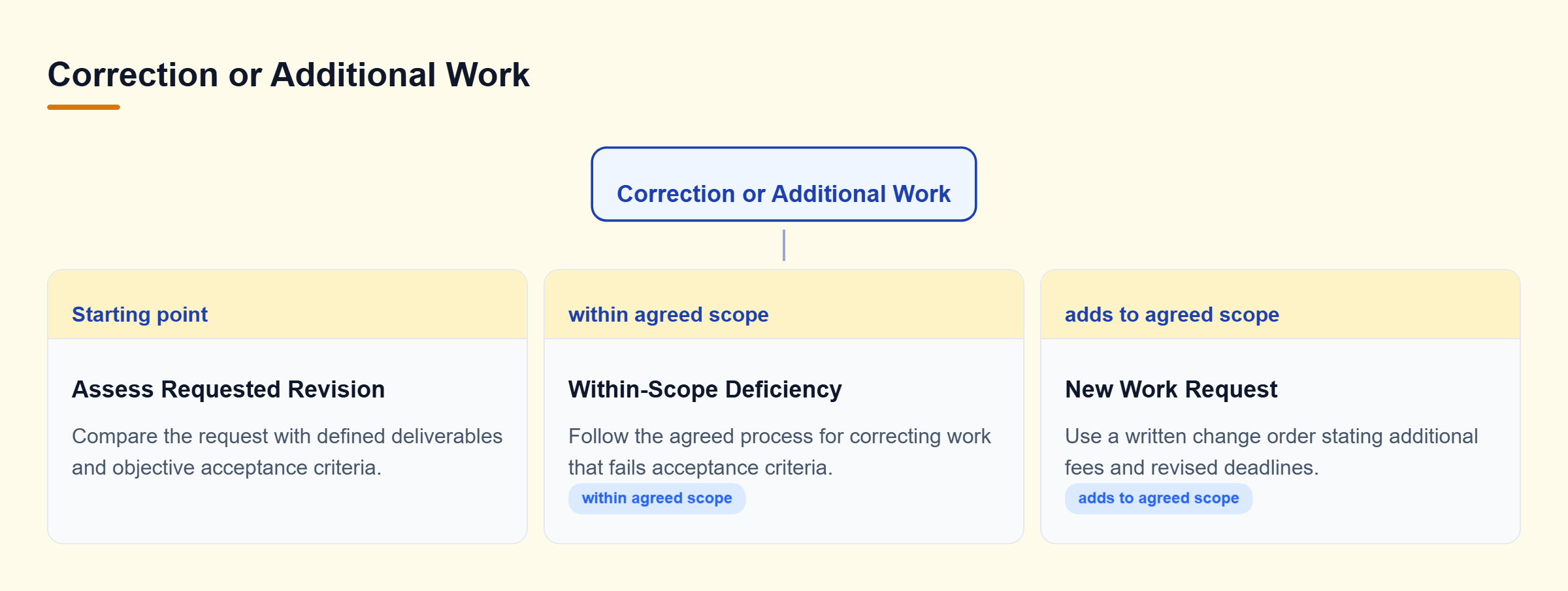

Set a review period, objective acceptance criteria, and a process for correcting deficiencies within the agreed scope. New requests should follow a written change-order process stating additional fees and revised deadlines, rather than become unpaid revisions.
2. Align Payment Terms with Applicable Freelance Protections
State the fee structure, invoice schedule, approved expenses, and payment date or determining mechanism. Explain how milestones affect payment without leaving approval open indefinitely.
Confirm Whether Article 44-a Applies
General Business Law Article 44-A covers qualifying independent contractors who are individuals or organizations composed of no more than one individual. Its $800 threshold includes contracts between the same parties during the immediately preceding 120 days; exclusions include specified sales representatives, attorneys practicing law, licensed medical professionals, and construction contractors.
Include Required Terms and Payment Dates
For covered engagements, the written contract must identify both parties’ names and mailing addresses, itemized services and their value, compensation rate and method, and payment date or determining mechanism. It must also specify when the freelancer must submit the service list needed for timely payment processing; the hiring party must provide a copy and retain the contract for at least six years.
Payment is due under the contract or, if neither a date nor a determining mechanism appears, within 30 days after completion. Once services begin, the hiring party cannot condition timely payment on accepting less than the contracted amount.
3. Separate Deliverable Ownership from Existing Materials
Receiving a report or project file does not itself transfer copyright. The agreement should distinguish newly created deliverables from existing templates, tools, and other materials that the consultant brings to the project.
Document the Intended Rights Transfer
Under federal copyright law, commissioned work qualifies as work made for hire only within specified statutory categories and with the required signed agreement. Otherwise, a copyright transfer generally requires a writing signed by the rights owner or an authorized agent; payment alone does not transfer ownership.
Identify the assigned rights and whether transfer occurs upon creation, delivery, or payment. If payment triggers ownership, address permitted use before payment and rights to unfinished work after termination.
License Materials Excluded from the Assignment
Identify pre-existing materials the consultant retains and define the business’s license to use them within the deliverables. Address modification, sharing with service providers, continued use after termination, and relevant third-party restrictions.
4. Coordinate Confidentiality, Liability, and Exit Terms
These provisions should reflect the information shared and the consequences of service failures. A consulting agreement should also explain what happens when the project ends early.
Define Confidential Information and Disclosure Exceptions
Identify protected information, authorized recipients, security duties, and the duration of confidentiality obligations. Include appropriate exceptions for public information, independently developed materials, lawful third-party sources, and legally required disclosures.
Clarify Liability Caps and Third-Party Claims
Specify whether a liability cap applies per claim or across the engagement, its exceptions, and its relationship to indemnification and insurance. For third-party claims, identify any defense obligation and who controls settlement.
Under New York law, courts generally respect negotiated commercial risk allocations, but public policy restricts provisions that immunize gross negligence or limit recovery for it to nominal amounts. Other meaningful liability or remedy limitations require separate analysis, so avoid assuming that every cap receives identical treatment.
Address Termination and Final Handover
Distinguish termination for convenience from termination for material breach, including notice and cure periods. Address earned fees, authorized expenses, unfinished deliverables, and any separately priced transition assistance.
Specify when the consultant must deliver files, return or delete confidential materials, and surrender system access, subject to appropriate retention exceptions. Identify payment, ownership, licensing, and confidentiality provisions intended to survive termination.
5. Questions to Resolve before Signing
A final review should check how the agreement works with proposals, statements of work, and project communications. Conflicting documents or unclear approval authority can undermine otherwise precise clauses.
Which Document Controls Conflicting Terms?
Set an order of precedence for the master agreement, statement of work, proposal, and change orders. If a statement of work may override the master agreement, require it to identify the provision being changed.
Can a Project Manager Approve Extra Fees by Email?
Identify who may authorize changes and which approval methods are acceptable. If email approval is permitted, require confirmation of the added services, fees, and revised deadlines.
